Aurora-Viewer: Free Primavera P6 XER file viewer for Windows
Aurora-Viewer allows users to open and view Primavera P6 schedules in the “.XER” file format, without needing a full Primavera license; for free.
⬇ Download the Aurora-Viewer installer on your Windows PC!
Download Aurora-Viewer for XER files PC Installer (676 MB)
If you can not download EXE files, here is the EXE installer in a ZIP file:
⬇ Download Aurora XER Viewer (ZIP) –> Works on Windows 10/11 — 100% safe and free!
Download Aurora-Viewer for XER files PC Installer ZIP file (674 MB)
Aurora-Viewer currently includes:

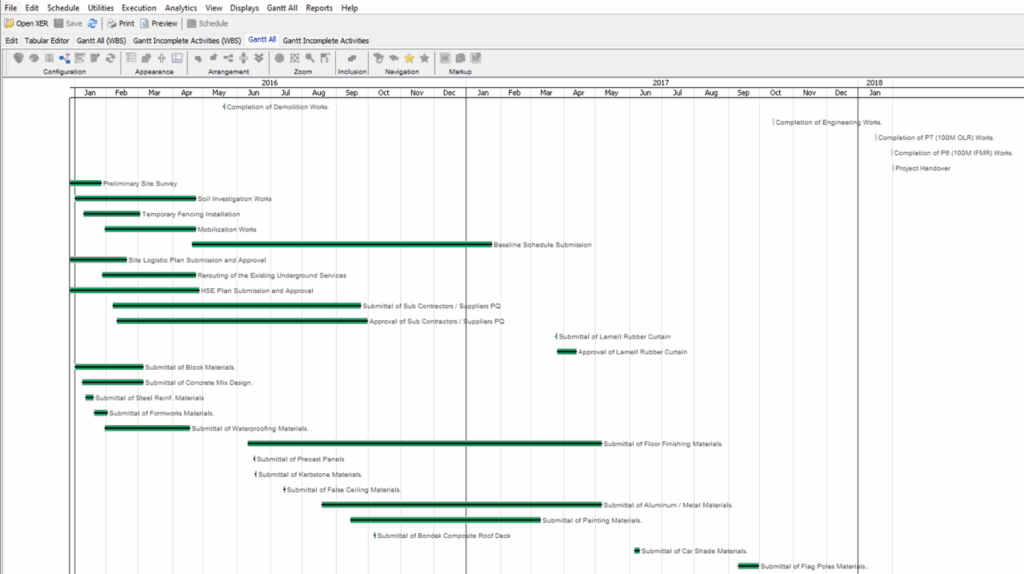

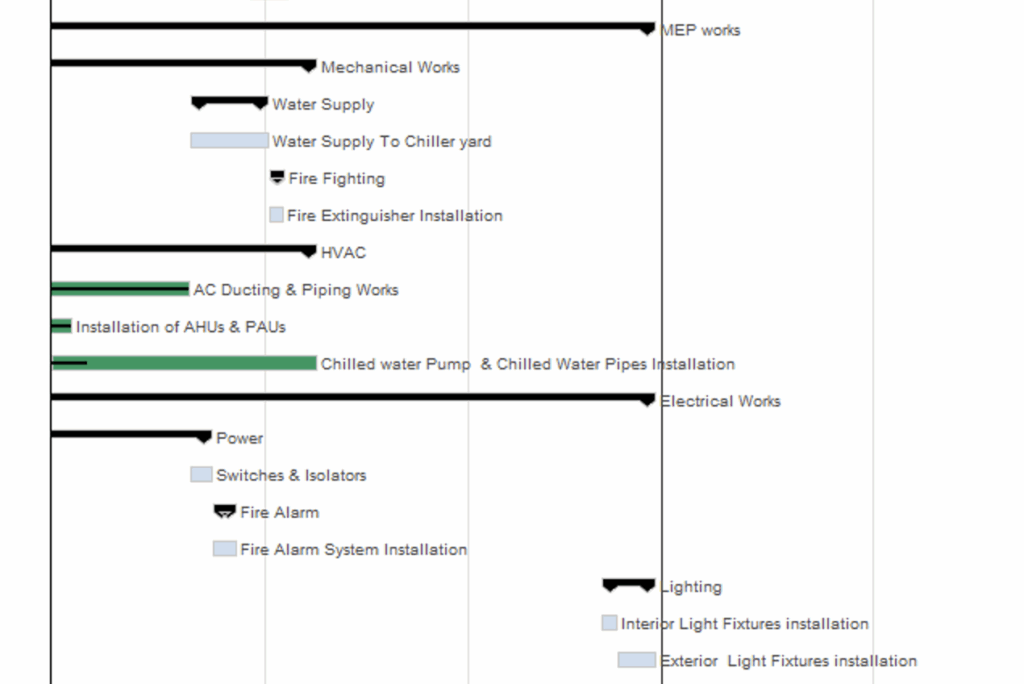

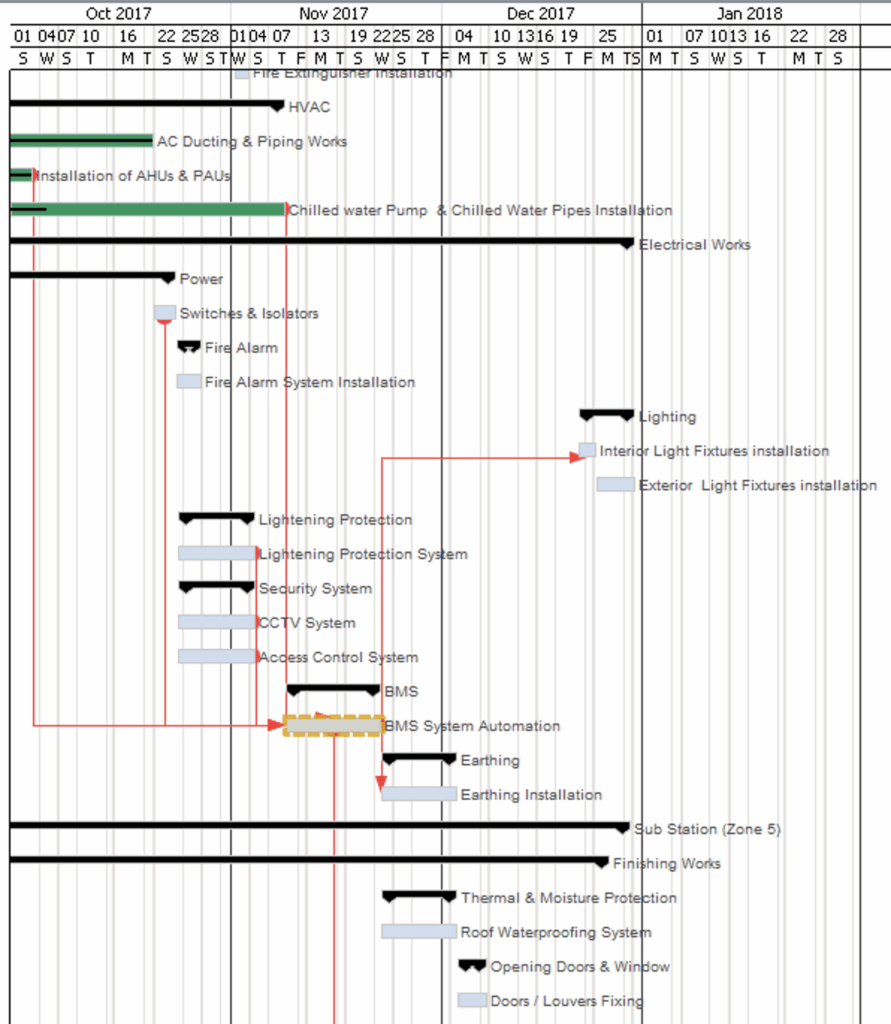

- Gantt Charts
- Get up to four Gantt charts when you import an XER file:
- Full Gantt with all activities
- Full Gantt with all activities and WBS summary bars
- Gantt with only incomplete activities
- Gantt with only incomplete activities and WBS summary bars
- Get up to four Gantt charts when you import an XER file:
- Tabular / spreadsheet view

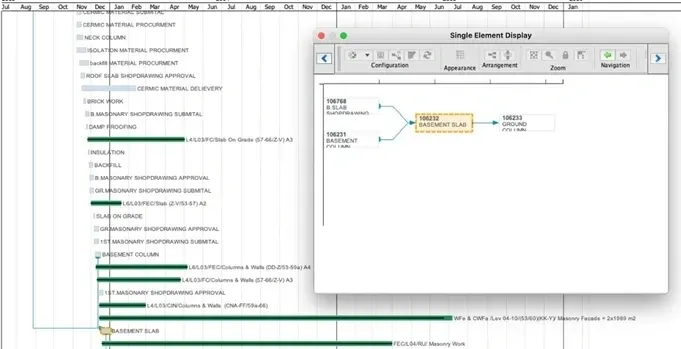

- Single-element view
- Project Overview report:
- shows the Project Overview Report by default after the user imports a .xer file
- a ‘minimum non-zero duration’ row has been added to the ‘activity details’ section
- a ‘zero duration jobs not marked as milestone’ row has been added to the ‘job types’ section
- a ‘calendars’ section has been added
- Reads critical path information directly from the XER file during import
- Tasks on the critical path are displayed in red, in both the PERT and Gantt charts
- Tasks with negative float are also shown in red, in both the PERT and Gantt charts
- A new Float section has been added to the Project Overview Report, which includes:
- Number of Zero Float activities
- Number of Negative Float activities
- The colors of links for the constraint types have been updated to:
- Finish-to-Start (FS) – Black
- Start-to-Start (SS) – Blue
- Finish-to-Finish (FF) – Green
- Start-to-Finish (SF) – Red
- Aurora now reads in total float data from the XER file during import
- A ‘Total Float’ column has been added to both the Tabular Editor and the Tabular Gantt
- Constraint Display Configuration is now available in all graphical views
- Legend option is turned on in all views

-
Zoom functions is turned on in all graphical views

- Utilities > Run Logic Checks
- Runs a set of model analysis methods to catch common modeling problems.
- Utilities > Find Redundant Constraints
- Shows redundant constraints.
- Reports > DCMA Report
- Shows a subset of the 14 DCMA audit points and any potential scheduling warnings/errors.
- Reports > Critical Path Predecessor Chart
- Shows how many tasks on the critical path have a certain number of predecessors. This provides insight into how much of the longest path through the network is susceptible to integration risk / merge bias. Integration risk / merge bias is the risk that one or more tasks feeding a successor task will be late, thereby delaying the start of the successor task. So in this case since the successor task is part of the longest path, then this will directly affect the end date of the project.

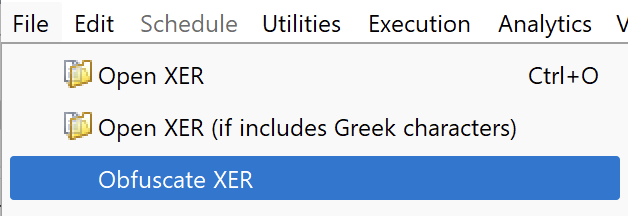

- File > Open XER (if includes Greek characters)
- Users can now open XER files where the text includes Greek characters. When such files are imported, the text, e.g., activity names, will be displayed correctly across the Aurora UI.
- Aurora-Viewer now supports an activity count up to 9,000 and a maximum file size of 20 MB
- Please use the feedback form below if you have models larger than the supported size
The latest version (September 2026 update) of Aurora-Viewer:
- Earned Value Management (EVM) enhancements:

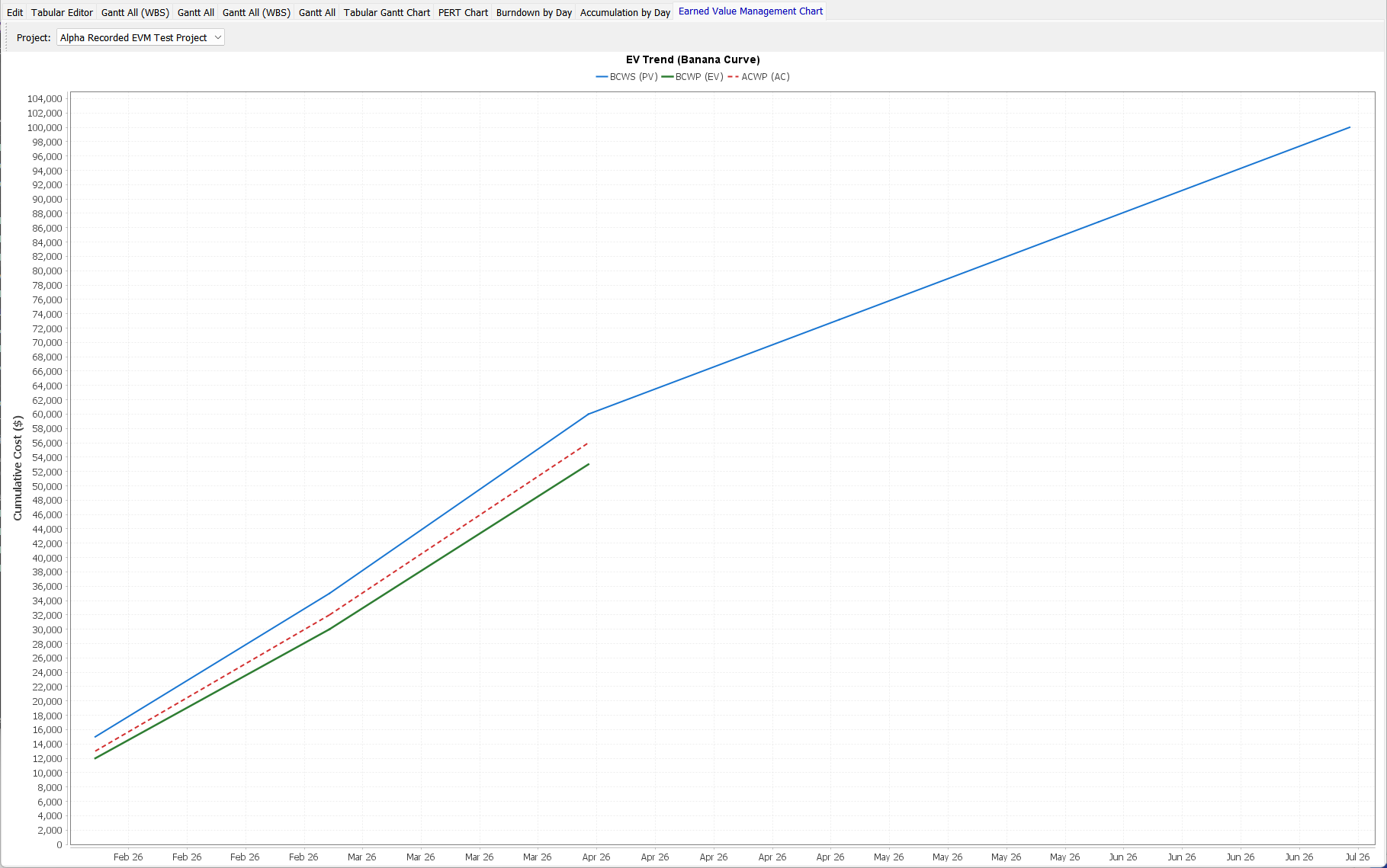

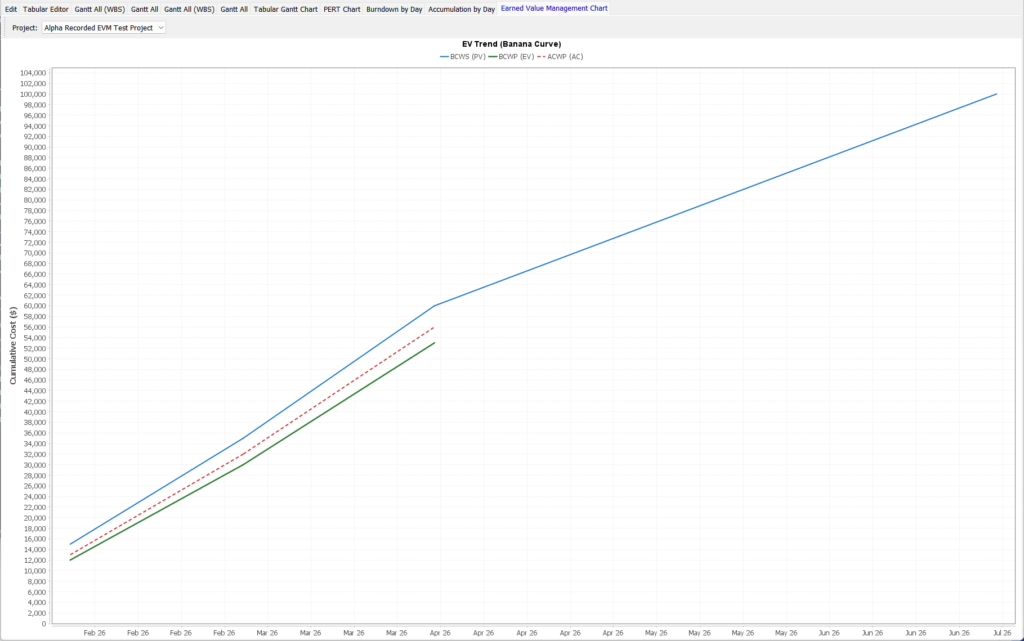

- When the imported project has EVM info, we auto-create an EVM chart as part of the default views. The EVM chart plots Planned Value (PV), Earned Value (EV), and Actual Cost (AC) over time so schedule and cost performance can be seen visually.
-
- The user can now select an XER file folder on their computer to scan. Once the scan is complete, a dialog appears displaying a table. There is one row for each XER file that displays the file name, whether the project encoded in the file has progress, and whether the project has EVM info.
- Additionally, the Project Overview report now has a line that tells the user whether the imported file has EVM info.

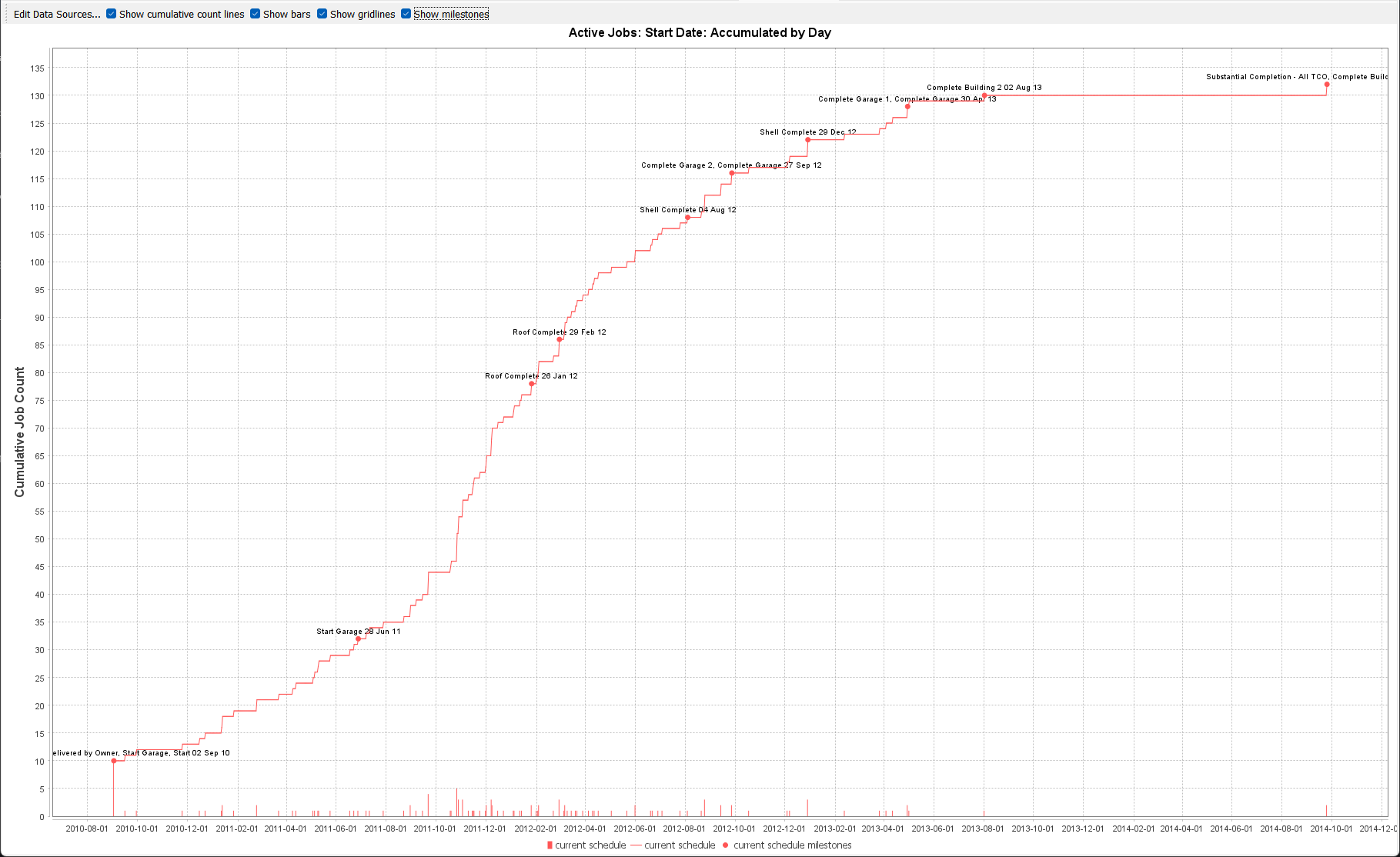

- If the imported project has at least one activity with a start date, the default views now include a Burndown chart and an Accumulated Activity chart.
- For installations where the user can import MPP files, EVM info is now read when the user imports such a file. This works similarly to the existing EVM functionality for XER files.
- Added critical path drag analysis. The user can initiate the analysis by clicking a menu item under the ‘Analytics’ menu. Once analysis completes, three views are auto-created: A Tabular Editor and two Gantt charts. These three views display the drag values, if present, for each activity.
See the demonstration videos below, the installation includes a “videos” subfolder with demonstration videos also. For example, see the Single-Element-Display video to learn how to better navigate and understand your schedule. Unlike other XER viewers on the market, including the Primavera P6 viewer, Aurora-Viewer has dedicated experts that can answer your questions; just fill out the feedback form below.
Who Can Benefit?
Non-Schedulers: Ideal for team members who only need to review schedules without making edits
Project Controls and Schedulers: Enables quick access to schedule data, facilitates report creation, and supports detailed analysis.
Advantages Over Traditional Methods
- Aurora-Viewer offers a dynamic alternative to static PDF printouts or Excel files.
- Simplifies the process of viewing, and sharing project schedules in real time.

Aurora-Viewer FAQs
What is Aurora-Viewer?
Aurora-Viewer is a free, standalone tool that allows users to open and view Primavera P6 XER files without requiring a full Primavera license. It provides an interactive and user-friendly interface for exploring project schedules.
What features does Aurora-Viewer offer?
Aurora-Viewer includes:
Gantt Charts: Visual representation of project timelines.
Tabular/Spreadsheet View: Detailed data in a grid format.
Single-Element View: Focus on individual tasks for in-depth analysis.
Project Overview Report: Summarizes key project details.

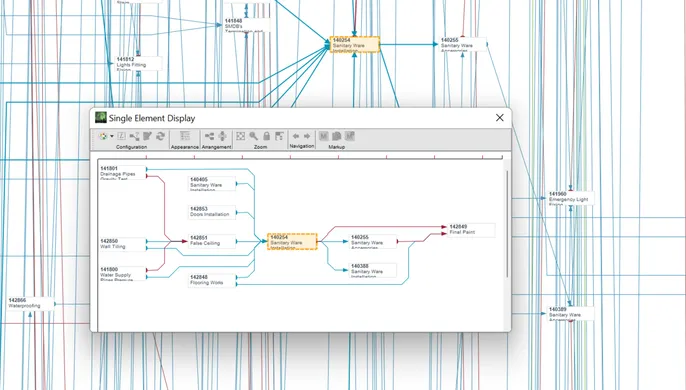

Network Diagram Navigation: Trace logic paths between activities.
Is Aurora-Viewer compatible with my system?
Aurora-Viewer is designed for Windows 10/11 and is available as a free installer (216.2 MB) or a ZIP file (217.9 MB). It is 100% safe to download and does not require Primavera P6 installation.
How can I get started with Aurora-Viewer?
To begin, download the installer or ZIP file from the official website. After installation, you can open XER files directly and utilize the various viewing options to explore your project schedules.
Is Aurora-Viewer free to use?
Yes, Aurora-Viewer is completely free to download and use. There are no hidden charges, subscriptions, or licensing fees — making it accessible for all project managers and schedulers who need to view Primavera XER files without purchasing Primavera P6.
Feedback
We plan to improve the Aurora-Viewer regularly so please return for updates and send us feedback on how you want Aurora-Viewer improved.
